Aggregate Conveyor Vulcanizing: Process Controls and Field Acceptance

  • product introduction
Posted by SINOCONVE On Oct 20 2026

Aggregate Conveyor Vulcanizing: Process Controls and Field Acceptance

Aggregate Conveyor Vulcanizing: Process Controls and Field Acceptance

Where does sound carcass begin, how will the belt be restrained and does the press cover the joint? Settle these before cutting. Name the release authority in the shutdown plan.

GET QUOTE - contact SINOCONVE about aggregate conveyor vulcanizing

01 Walk the Splice Station Before the Shutdown

Visit the station. Measure access for the press and check the lifting position, platform and support. Use actual belt and press masses in the handling plan.

Ask operations what will run nearby. Washing, screens and traffic can affect a stopped belt. Agree the shutdown boundary and barriers.

Check Power Under the Intended Load

Have an electrician check the supply with heaters and auxiliaries accounted for, including cable runs, protection and generator capacity.

Allow for Weather at the Work Position

Look beneath the shelter as well as through its doorway. Wind can reach a lower platen under the roof. Trace where rainwater will go and check the ventilation needed for the work.

02 Read the Marking, Then Check the Belt

Put a current photo of the belt marking beside the original order. Add site measurements of width, total thickness and covers, then identify the reinforcement and strength rating. Describe repairs at either end to the belt supplier. Sort out differences while the kit is still being selected.

The construction and selected kit need their own cure schedule. A cover measurement by itself leaves too much unanswered.

Steel-Cord Construction

Obtain the cord layout with diameter, pitch, cut positions and rubber spacing. Splice length is not automatically belt width. A two-step cord pattern describes geometry, not two heating cycles.

Check exposed cords for damage or corrosion under the supplier's assessment procedure. Cover rubber placed over a damaged cord bed cannot restore its tensile load path.

EP and NN Fabric Belts

Confirm fabric type and ply count. The product may need a step, finger or special joint. Supply operating tension and conveyor details for engineering review; incline angle alone cannot set step length.

03 Approve the Geometry Before Cutting

Put the drawing revision on the job sheet, with end orientation, references, cover transitions and belt allowance. Check remaining length and take-up travel against the proposed cutout.

A normal fabric step joint often has one fewer step than plies. Overlap and special layouts differ, as shown in these splicing manuals. Keep the applicable drawing beside the work.

steel cord conveyor belt sections with cord reinforcement

Keep the Belt Centre References

Establish longitudinal references over sound belt on both sides, keeping them visible through preparation. A worn edge is a poor sole reference. Recheck alignment before closing and photograph the measured layout.

Check pulleys, transitions and loading on the crusher belt. Extra splice length cannot correct unsuitable conveyor geometry.

04 Prepare the Interface Without Damaging It

During stripping, the proposed repair boundary may prove too short. Moisture, separation or damaged reinforcement beyond it calls for a fresh assessment before assembly continues.

Clean to the specified finish while keeping the reinforcement intact. Protect the finished face from debris thrown by nearby cutting or grinding.

Consult the kit instructions for cleaner use and safety. Internal moisture needs assessment before assembly, even when the cover feels dry.

05 Put the Cycle Beside the Press

Put sensor positions on the cycle sheet beside the timing, temperature, pressure and cooling requirements. Identify which readings govern each stage. The location matters: a surface reading tells the operator about the surface.

Match the usable heated and pressurised area to the complete splice and specified margins. Do not move a short press along it without express approval from the belt and splice-system suppliers. Sectional platens covering the joint together differ from sequential heating.

See the steel-cord instructions for one manufacturer's example. Request the procedure for your belt.

Follow the cooling and pressure-release conditions. Allow time for them. A delayed job does not authorise a higher setpoint or early opening.

06 Schedule Several Joints as Separate Jobs

Schedule each joint from access and isolation through cooling and inspection, then add moves between stations. A shared crane or press can delay another crew.

Work back from restart and mark the last safe deferral point. Sequence around access and resources; neither distance from the drive nor a fixed joints-per-shift figure settles it.

Assign the Work and the Checks

List the competent people handling isolation, rigging, assembly, press operation and inspection. Size the crew for concurrent work.

Check restraints, rigging, instruments and cooling supply against the method before leaving. Bring pressure equipment and spares for the selected press.

07 Keep Dust Out During Assembly

Isolate under the site procedure and secure take-up loads, rollback and stored tension through the engineered restraint plan. Motor lockout alone does not secure every part.

Separate Preparation From Clean Assembly

Keep waste outside assembly. Protect materials with their liners and clean tools before contact. A floor sheet does not make dropped material usable.

Keep fines from nearby plant and traffic outside the shelter. If contamination reaches a prepared face, stop and use the specified recovery method.

Check the Solution Instructions

Use the solution as part of its matched system. Follow its coating locations, quantity and drying conditions, including compound restrictions. A universal two-coat rule is unsuitable.

08 Set Conditions for Stopping the Job

Check weather for the hours while the joint is open. Look around the shelter for incoming grit, leaks and condensation reaching the work.

What Conditions Will the Crew Record?

Review shelter anchorage, access, drainage and ventilation with the lift. Make the environmental checks in the method. For condensation checks, record the surface temperature and local dew point together.

A wet face, drifting dust or lost pressure control needs a planned response. Set the stopping and recovery rules before work, including unsafe access and supply failures. Name who can authorise the repeated steps.

09 Agree Field Acceptance Before Mobilisation

Agree the inspection method, criterion and responsible person before mobilisation. Record observations separately from measurements. Appearance does not measure adhesion throughout a joint.

Acceptance item Evidence to retain Action when evidence is unacceptable
Surface and edge inspection Photos and observations against agreed finish criteria Record blisters, exposed reinforcement, lifts or abnormal areas for disposition
Alignment and dimensions Reference method, measured geometry and drawing revision Resolve departures from the approved tolerances before release
Tap survey, if specified Mapped observations from the agreed screening method Refer suspicious areas for assessment; sound alone cannot grade bond strength
Instrumented inspection Qualified technique, coverage, limitations and interpreted report Assess indications against criteria established for that construction
Witness specimen, if required Preparation, thermal history, test method and laboratory result Review representativeness and results under the agreed acceptance plan

Know What Each Check Can Establish

Agree the defect being sought before specifying ultrasound, then qualify the technique for that construction. A magnetic survey of steel-cord belts addresses cord and splice changes. Rubber adhesion needs a different basis for assessment.

Agree what the witness specimen represents: its thickness, restraint and heating may differ from the installed joint. Report peel and tensile tests under their respective criteria.

10 Plan the First Runs and Follow-Up

Use the site's restart procedure after release, with tools and restraints removed and guards restored. Agree no-load and loaded checks, observation positions and stop conditions.

Give the Next Shift a Specific Watch List

Watch tracking, edge clearance, transfers and cleaner contact. Record lifts or interference. Isolate again for hands-on inspection.

Set inspection intervals around the duty, including the first runs and any later shift checks. Keep full-load release tied to the acceptance and restart plan. Merely reaching 72 hours says little about cure.

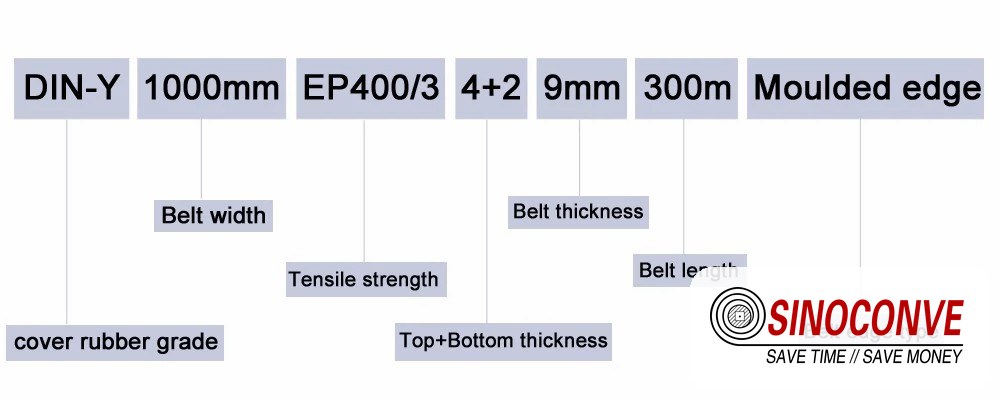

steel cord conveyor belt specification drawing

11 Choose Between a New Splice, Fasteners and Replacement

Check sound ends, remaining length and the failure cause before quoting another repair.

Belt condition or constraint Option to assess Decision needed before work
Local failure with sound ends available Cutout and approved hot splice Confirm geometry, belt allowance and expected splice performance
Widespread wear or carcass deterioration Replacement belt or engineered replacement section Establish the extent of damage and a workable installation plan
Short window on a suitable fabric belt Rated mechanical fastening system Check tension, thickness, pulley and cleaner compatibility
Failure within a steel-cord splice Specialist assessment and engineered rebuild Establish sound cord length; a cover patch cannot restore the tensile connection
Deteriorated belt awaiting replacement Restricted interim operation only if approved Confirm that any proposed connection and remaining belt can safely carry the duty

Check the Fastening System's Actual Limits

A rated fastener may remain in service on a suitable duty. For steel-cord systems, obtain belt-specific selection. A connection intended for fabric needs its own suitability review before considering it elsewhere.

The offer should state the performance basis of the chosen splice design. Hot vulcanizing alone is no promise of the parent belt's full rating.

12 Investigate Early Cracks Before Repeating the Repair

Retain the cycle record, photos and removed material where practical. Note when damage appeared and the loading points, transitions and cleaners it passes.

Finding Record on the stopped belt Items to investigate Correction to verify
Cracks near a cover transition Location, direction and extent Geometry, flexing, load and material compatibility Approved transition detail and conveyor conditions
Uneven or displaced joint Thickness and longitudinal alignment Preparation, assembly movement and restraint Drawing dimensions and stable setup
Soft, porous or lifted edges Extent and surface condition Pressure containment, heating, materials and contamination Edge-bar arrangement and the recorded cycle
Separation above the cord bed Position relative to cords and covers Moisture, trapped air, preparation and cure deviations Engineered repair scope and assembly method

Investigate an edge crack before blaming step length. More heat leaves damage, displacement or contamination in place. Refer proposed further curing to the supplier for written disposition.

13 Leave a Record That Identifies This Joint

Include the Measurements and Any Departures

Identify conveyor, joint, belt, drawing revision and location. Add kit codes, batches, expiry and storage history, plus crew and press identification. Keep instrument checks, sensor positions and the recorded cycle.

Record pressures, stage times, cooling and release conditions, separating settings from measurements. Attach departures and dispositions, test reports and signed release. Make restrictions visible to the next shift.

14 Use the General Method Alongside the Site Plan

Use the general splicing guide alongside the site plan. Resolve quarry access, weather and resources before mobilisation. The belt-specific instruction governs the work.

With the enquiry, send SINOCONVE the belt details, duty, damage photos and shutdown scope. Mark the supply and contractor boundaries on the returned quotation, including materials and technical documents.

aerial view of a quarry haul road

Get a quote from SINOCONVE for aggregate conveyor vulcanizing

15 Frequently Asked Questions

Where does the extra site time go?

Price the access, restraint and shelter work at the actual station. Add cooling and inspection to the duration. A workshop estimate may leave those site tasks uncovered.

Is site splicing an option for steel cord?

Site work is possible with a design, kit and press arrangement approved for that belt. Confirm full coverage while booking the press. Cord steps belong to the layout; the cure procedure defines the heating sequence.

Will the work fit a twelve-hour stop?

Travel and shared equipment can determine the finish time. Put the task durations into a schedule to see which jobs have to wait for others.

Should dust be blamed first?

Quarry dust deserves control throughout preparation. For a failed splice, look at the records and damage before ranking causes. Geometry, materials, workmanship, cure and conveyor loading all belong in that review.

Must the whole plant stop?

Assess the work area to set the shutdown boundary. That includes securing the belt and stored loads, plus any neighbouring work that puts the crew or prepared joint at risk.

Who releases full-load operation?

Name the release authority in the acceptance plan. That decision follows the cure, cooling and restart requirements, with any staged loading agreed in advance.

Can mechanical fasteners be permanent?

Yes, where the selected system and belt are suitable for the duty. Obtain the relevant ratings and check the pulleys, cleaners and conveyed material. Steel-cord applications require a system designed for that construction.

Which weather conditions stop the work?

Use the limits in the work plan and inspect conditions inside the shelter. Loss of protection, safe access or lifting conditions may stop the job even when a weather reading appears acceptable.

How can acceptance proceed without cutting the joint?

Use the agreed process record, dimensional inspection and applicable nondestructive checks. State their limitations. Destructive or witness testing needs its own agreed method and acceptance basis.

Should the quarry keep splice materials in stock?

Allow for expiry and the specified storage conditions when deciding what to keep. The stock plan needs an owner and a replacement date, with quantities based on the response time required.
